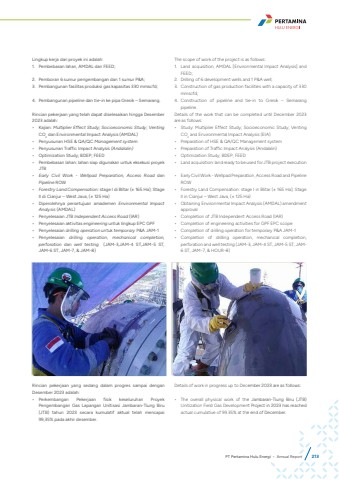

                                    Lingkup kerja dari proyek ini adalah:1. Pembebasan lahan, AMDAL dan FEED;2. Pemboran 6 sumur pengembangan dan 1 sumur P&A;3. Pembangunan fasilitas produksi gas kapasitas 330 mmscfd;4. Pembangunan pipeline dan tie-in ke pipa Gresik %u2013 Semarang.Rincian pekerjaan yang telah dapat diselesaikan hingga Desember 2023 adalah:%u2022 Kajian: Multiplier Effect Study; Socioeconomic Study; VentingCO2 dan Environmental Impact Analysis (AMDAL)%u2022 Penyusunan HSE & QA/QC Management system%u2022 Penyusunan Traffic Impact Analysis (Andalalin)%u2022 Optimization Study; BDEP; FEED%u2022 Pembebasan lahan: lahan siap digunakan untuk eksekusi proyek JTB %u2022 Early Civil Work - Wellpad Preparation, Access Road dan Pipeline ROW%u2022 Forestry Land Compensation: stage I di Blitar (%u00b1 165 Ha); Stage II di Cianjur %u2013 West Java, (%u00b1 125 Ha)%u2022 Diperolehnya persetujuan amademen Environmental Impact Analysis (AMDAL)%u2022 Penyelesaian JTB Independent Access Road (IAR)%u2022 Penyelesaian aktivitas engineering untuk lingkup EPC GPF%u2022 Penyelesaian drilling operation untuk temporary P&A JAM-1%u2022 Penyelesaian drilling operation, mechanical completion, perforation dan well testing (JAM-3,JAM-4 ST,JAM-5 ST, JAM-6 ST, JAM-7, & JAM-8)The scope of work of the project is as follows:1. Land acquisition, AMDAL [Environmental Impact Analysis] and FEED;2. Drilling of 6 development wells and 1 P&A well;3. Construction of gas production facilities with a capacity of 330 mmscfd;4. Construction of pipeline and tie-in to Gresik %u2013 Semarang pipeline.Details of the work that can be completed until December 2023 are as follows:%u2022 Study: Multiplier Effect Study; Socioeconomic Study; Venting CO2 and Environmental Impact Analysis (EIA)%u2022 Preparation of HSE & QA/QC Management system%u2022 Preparation of Traffic Impact Analysis (Andalalin)%u2022 Optimization Study; BDEP; FEED%u2022 Land acquisition: land ready to be used for JTB project execution%u2022 Early Civil Work - Wellpad Preparation, Access Road and Pipeline ROW%u2022 Forestry Land Compensation: stage I in Blitar (%u00b1 165 Ha); Stage II in Cianjur %u2013 West Java, (%u00b1 125 Ha)%u2022 Obtaining Environmental Impact Analysis (AMDAL) amendment approval %u2022 Completion of JTB Independent Access Road (IAR) %u2022 Completion of engineering activities for GPF EPC scope%u2022 Completion of drilling operation for temporary P&A JAM-1%u2022 Completion of drilling operation, mechanical completion, perforation and well testing (JAM-3, JAM-4 ST, JAM-5 ST, JAM6 ST, JAM-7, & HOUR-8)Rincian pekerjaan yang sedang dalam progres sampai dengan Desember 2023 adalah:%u2022 Perkembangan Pekerjaan fisik keseluruhan Proyek Pengembangan Gas Lapangan Unitisasi Jambaran-Tiung Biru (JTB) tahun 2023 secara kumulatif aktual telah mencapai 99,35% pada akhir desember.Details of work in progress up to December 2023 are as follows:%u2022 The overall physical work of the Jambaran-Tiung Biru (JTB) Unitization Field Gas Development Project in 2023 has reached actual cumulative of 99.35% at the end of December.PT Pertamina Hulu Energi %u2022 Annual Report 213

   209   210   211   212   213   214   215   216   217   218   219
